That confusion causes real cash flow problems. Contractors wait on payment. Subcontractors get nervous. Timelines slip because nobody understood the draw process going in.
Understanding how draw schedules work keeps your project on time, on budget, and moving toward the next disbursement without friction. This guide breaks down how draws function, how schedules are typically structured, and how to avoid the delays that trip up most first-time investors.
Key Takeaways
- Construction loans fund projects in stages tied to completed work—not in one lump sum
- A draw schedule locks milestones, timing, and dollar amounts agreed by borrower, lender, and inspector
- Draw requests require documentation and usually pass inspection before funds are released
- Payments during construction are typically interest-only on the amount drawn so far
- An investor-focused lending network like Kingdom Capital Financial can help coordinate construction financing and draw timing
What Is a Construction Loan Draw?
A draw is a partial disbursement of your loan funds, released to reimburse you or your contractor for work already completed or materials already purchased. Think of it as a reimbursement system rather than an advance.
Lenders don't hand over the full loan amount at closing. According to guidance from the Office of the Comptroller of the Currency, banks structure construction payouts this way to manage risk and confirm disbursed funds match actual project progress. If a project stalls or a contractor disappears, the lender hasn't released money for work that never happened.
Three terms get used interchangeably, but they mean different things:
- Draw: the actual disbursement of funds
- Draw schedule: the pre-agreed roadmap for when and how much gets released
- Draw request: your formal submission asking for a specific draw, backed by invoices and proof of work

Who Is Involved in the Draw Process

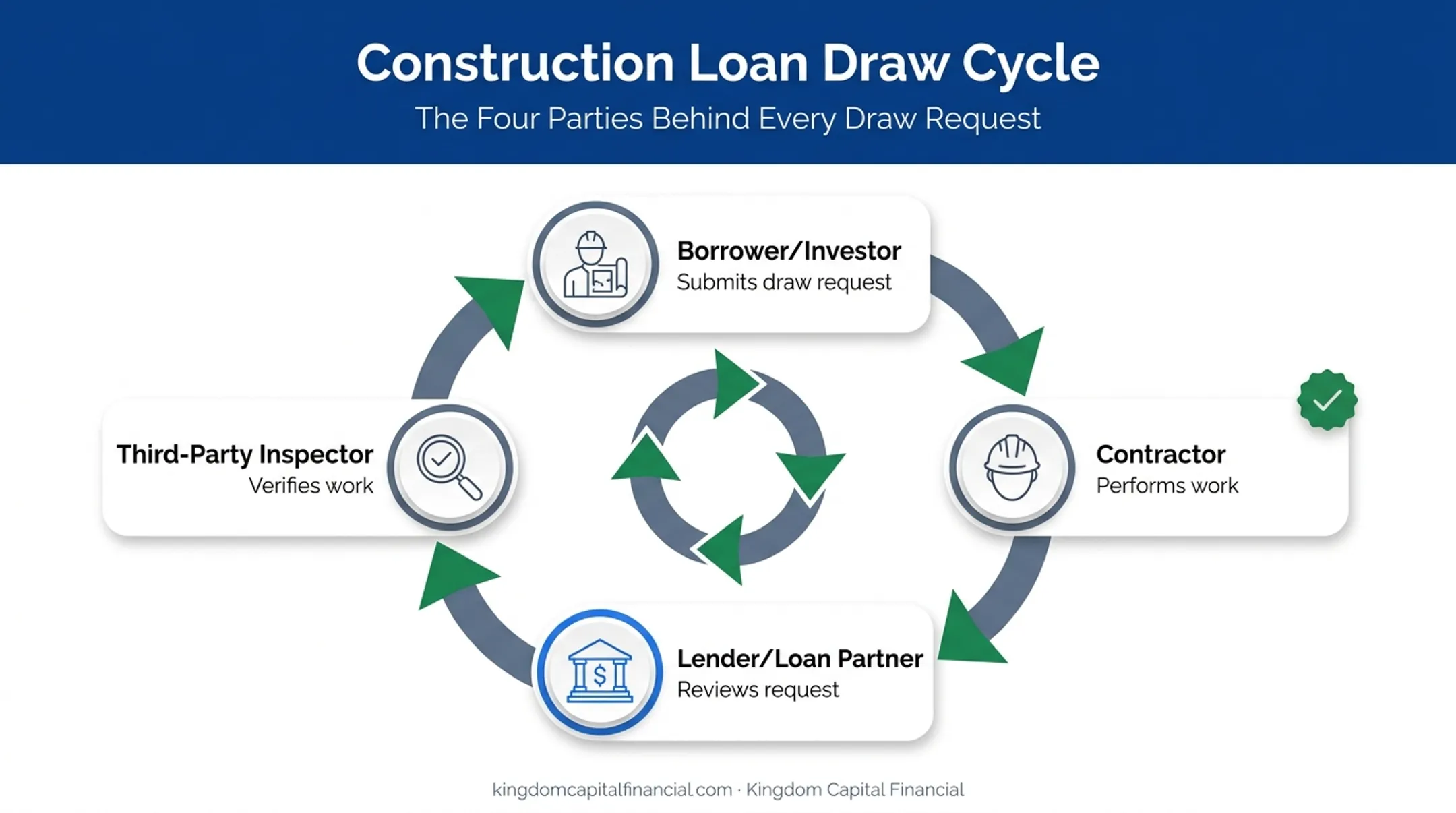

Every draw typically involves four parties:
- Borrower/investor: submits the request and manages the project
- Contractor: performs the work and often prepares supporting documentation
- Lender or loan partner: reviews the request against the schedule
- Third-party inspector: verifies the work matches what's being billed
For investors funding ground-up or renovation projects, understanding draws upfront makes it easier to structure construction financing with a partner like Kingdom Capital Financial and keep capital aligned with real progress.
Understanding the Construction Draw Schedule
A draw schedule is the pre-agreed timeline mapping out what percentage or dollar amount gets released at each construction milestone. It's negotiated before closing, not improvised mid-build.
Two common structures:
- Milestone-based draws: funds release when a specific phase finishes (foundation poured, framing complete, roof on)
- Fixed-interval draws: funds release monthly or twice-monthly on larger projects, regardless of exact milestone completion
What a Typical Schedule Looks Like
The OCC notes that a standard residential construction payment plan commonly consists of five installments, with the first four tied to verified construction stages.
National investor lenders like LendingOne report 4 to 6 typical draws: an initial draw at closing, followed by foundation, framing, mechanical systems, and a final draw.
A sample percentage breakdown might look like:

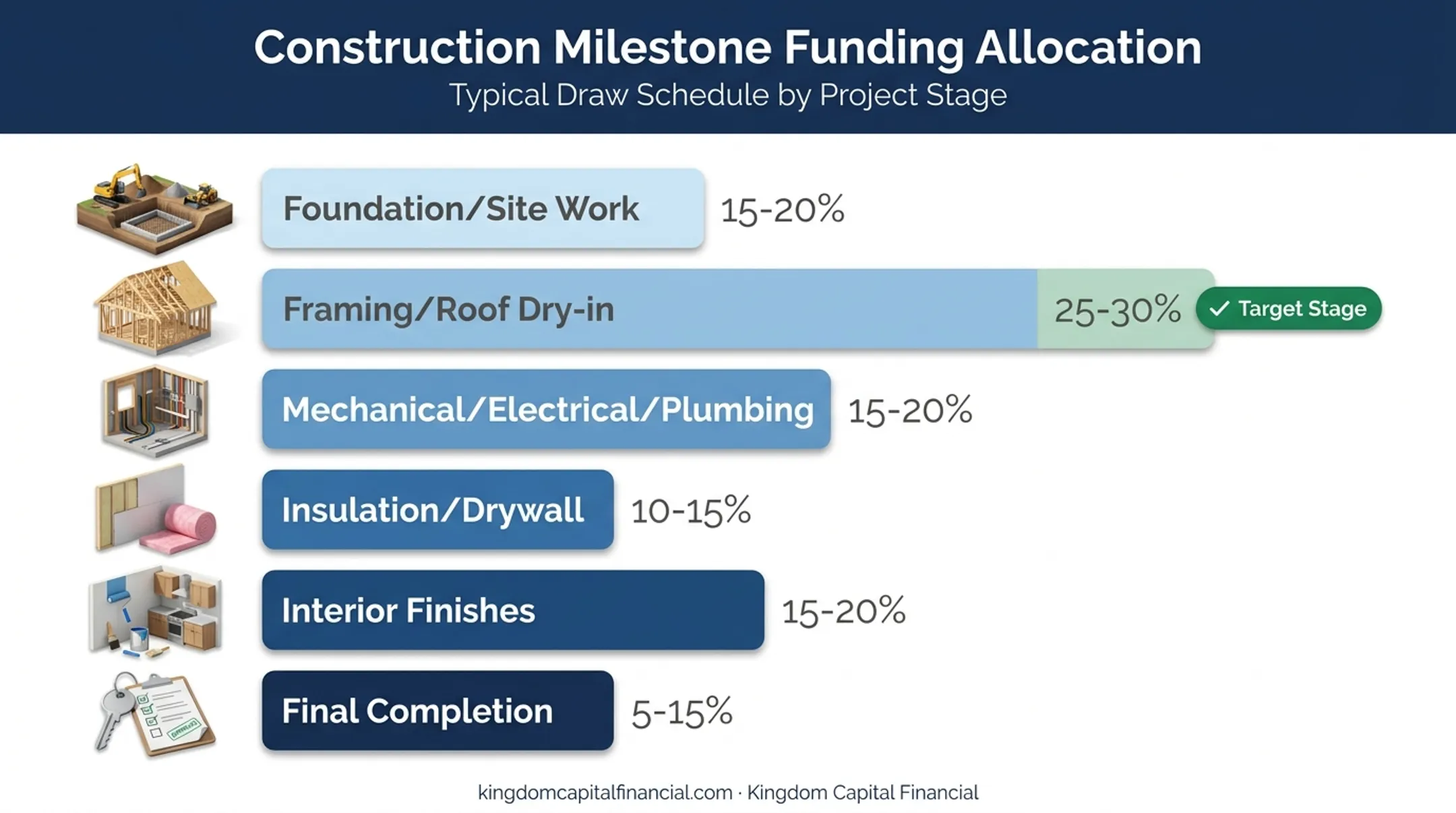

| Milestone | Typical Allocation |
|---|---|
| Foundation/site work | 15-20% |
| Framing/roof dry-in | 25-30% |
| Mechanical/electrical/plumbing rough-in | 15-20% |
| Insulation/drywall | 10-15% |
| Interior finishes | 15-20% |
| Final completion | 5-15% |

These percentages vary by lender, project type, and scope, so treat any single example as illustrative rather than universal.
Draw schedules are also customized. Kingdom Capital Financial structures ground-up construction and fix-and-flip financing around each project's costs and exit strategy. That flexibility matters when your build has an unusual scope or timeline.
When Change Orders Enter the Picture
Even a well-built schedule can shift once work is underway. Change orders—unplanned scope or budget changes—often force the lender to re-evaluate remaining draw amounts. Flag them early with your loan partner so you avoid bigger funding delays later.
How the Draw Request and Disbursement Process Works

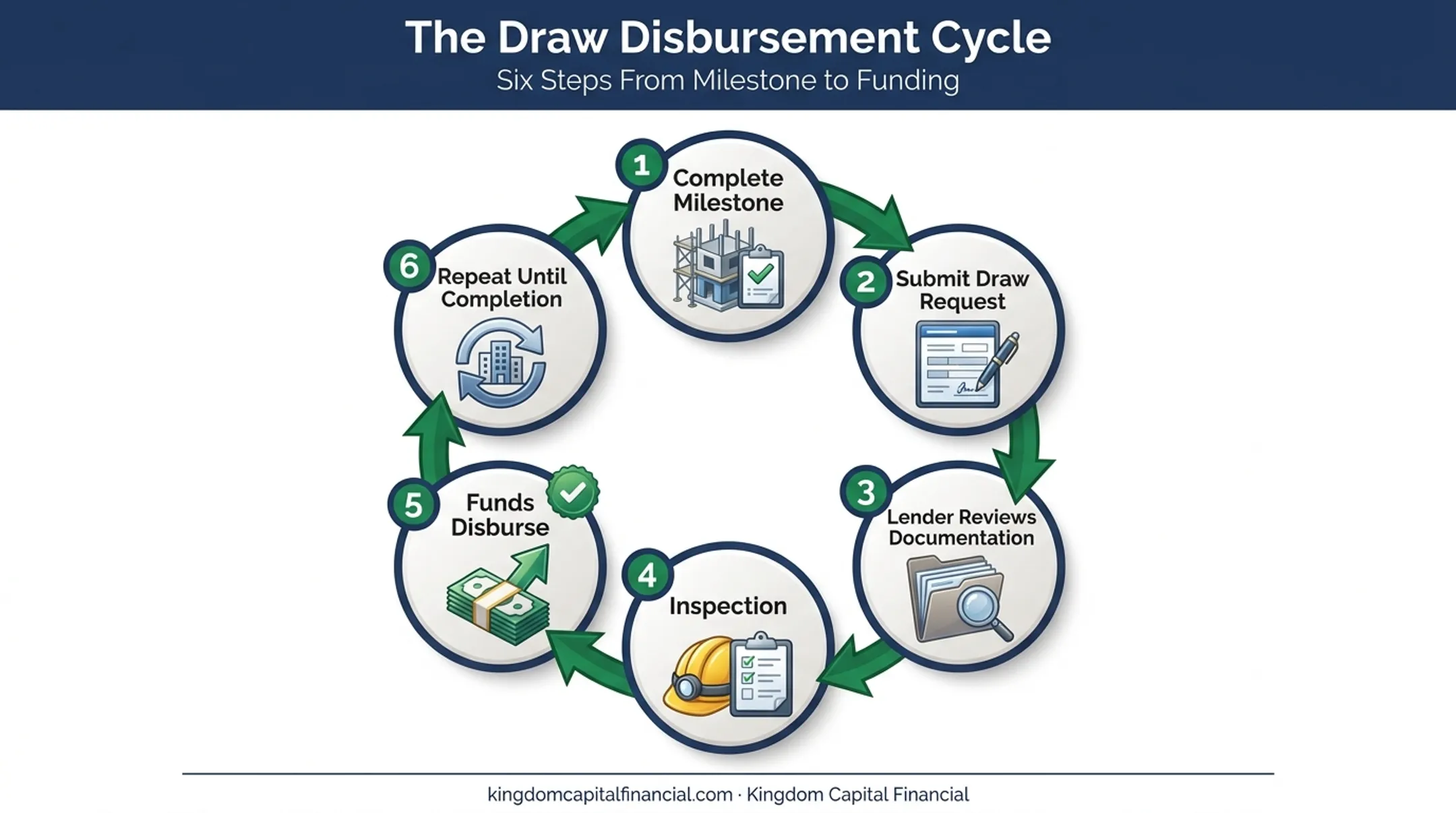

The disbursement cycle repeats at every milestone. The general sequence looks like this:
- Complete a milestone — the contractor or borrower finishes the agreed phase of work
- Submit the draw request — include invoices, receipts, and proof of completed work
- Lender reviews documentation — checking accuracy against the original draw schedule
- Inspection — a lender-assigned or title company inspector verifies the work matches the request
- Funds disburse — either directly to the contractor or into a controlled account
- Repeat until completion — the cycle continues through the final draw

The FDIC's construction lending guidance emphasizes that inspections should precede every disbursement. Lien waivers should be signed before funds move, protecting both borrower and lender from unpaid subcontractor claims.
Timing varies widely. Some lenders wire funds within 2-5 business days of approval. Others need 5-7 business days for approval plus another 1-3 days for payment, pushing the total closer to two weeks. Ask your loan partner directly what turnaround to expect on your specific program.
How Much Can You Borrow and How Are Payments Calculated?
Construction loan sizing typically weighs two things: your total project budget and the property's projected after-completion value, not just the current land value. Most lenders size loans at 75% to 90% of cost, with after-completion value caps often between 65% and 75%—exact figures depend on the lender and borrower profile.
Payments work differently than a standard mortgage.

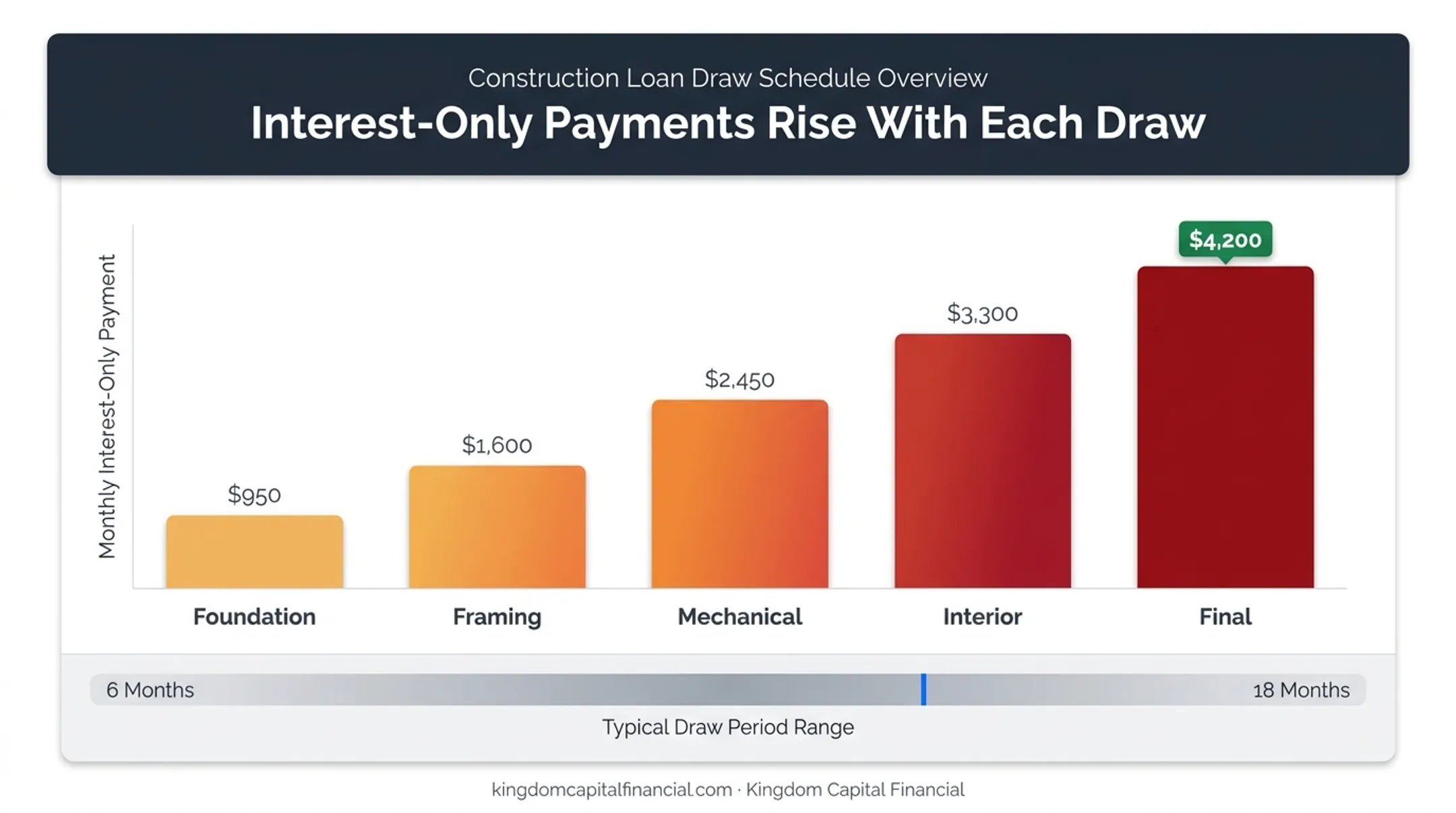

- During construction, you typically pay interest-only
- Interest is calculated on the drawn balance, not the full approved loan amount
- As you take more draws, your outstanding balance grows — and so does your monthly payment
So your first payment after the foundation draw looks a lot smaller than your payment after the framing and mechanical draws have both landed.
That interest-only phase only lasts as long as the draw period. Draw periods commonly run 6 to 18 months, depending on project scope. Ground-up builds often stretch longer (12-24 months in some lender programs), while fix-and-flip rehabs usually stay in the 6-18 month range.

Best Practices to Avoid Draw Delays
Delays almost always trace back to the same handful of preventable issues. Keep these habits tight and you'll avoid most of them:
- Organize documentation as you go: file invoices, lien waivers, and receipts at each milestone, not after the fact
- Submit draw requests promptly so cash flow gaps don’t strain subcontractor relationships
- Flag timeline or budget changes early so your lender isn’t surprised by a change order
- Stay permit- and code-compliant; a failed inspection can stall an entire draw
Missing signatures, incomplete forms, and scheduling conflicts between contractor, borrower, and bank still cause most draw delays. Upfront organization and early communication prevent nearly all of them.
Why Choose an Investor-Focused Lender for Construction Draws
Working with a lending network that understands investor timelines makes a real difference. Banks built around traditional retail mortgages aren't always set up to move quickly on milestone-based construction draws.
Investor-focused construction financing is usually built for how draws actually run:
- Reviews tied to completed, inspectable work—not retail mortgage timelines
- Schedules matched to ground-up and value-add milestones
- Exit planning that fits the project, whether you refinance, sell, or hold
Kingdom Capital Financial connects real estate investors nationwide with construction and fix-and-flip loan programs designed for ground-up development and value-add projects. Investor loan partner Santino Salanitri, for example, specializes in ground-up construction, fix-and-flip, DSCR, and commercial loans, so your file goes to someone who has structured these deals before.
For investors managing multiple projects at once, a loan partner who understands draw mechanics and project-specific exits helps keep capital releasing on schedule instead of stalling between inspections.
Frequently Asked Questions
How much can I borrow on a construction loan?
Loan amounts are typically based on your total project cost and the property's projected after-completion value, though exact limits vary by lender and borrower qualification. A loan partner can evaluate your specific project to determine your borrowing capacity.
How are funds disbursed on a construction loan?
Funds are released in draws tied to completed milestones. Each draw generally requires an inspection and documentation review before the lender approves disbursement.
What is a draw in a construction loan?
A draw is a partial disbursement of your loan funds, released to reimburse completed work or purchased materials based on project progress rather than as a lump sum.
What is the draw period on a construction loan?
Draw periods commonly run 6 to 18 months, depending on project size and scope. Larger ground-up builds often run longer than smaller rehab or fix-and-flip projects.
How are monthly payments calculated on a construction loan?
Payments during construction are typically interest-only, calculated on the balance you've actually drawn, not the full loan amount. As you take more draws, your payment increases accordingly.
